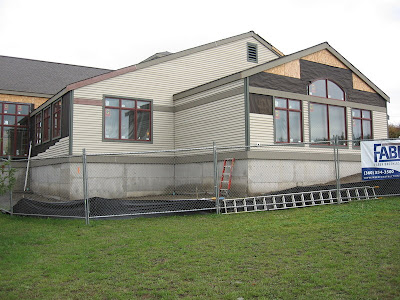

Week 16 saw continued progress. Siding on the west side of the building has now been completed although much remains to be done on the rest of the building. A rough estimate would be that about 50% of the siding has now been installed. Interior work continued during the week. Installation of sheet rock was completed and work began taping the seams. The remaining two (of four) solar tubes bringing light in from the cupola were also installed. The photos below show some of the progress made during the week.
seams that are completely invisible.
